1. Project Name: Construction of Tien Duong 2 Social Housing Area
2. Sector/Field: Urban Area, Housing

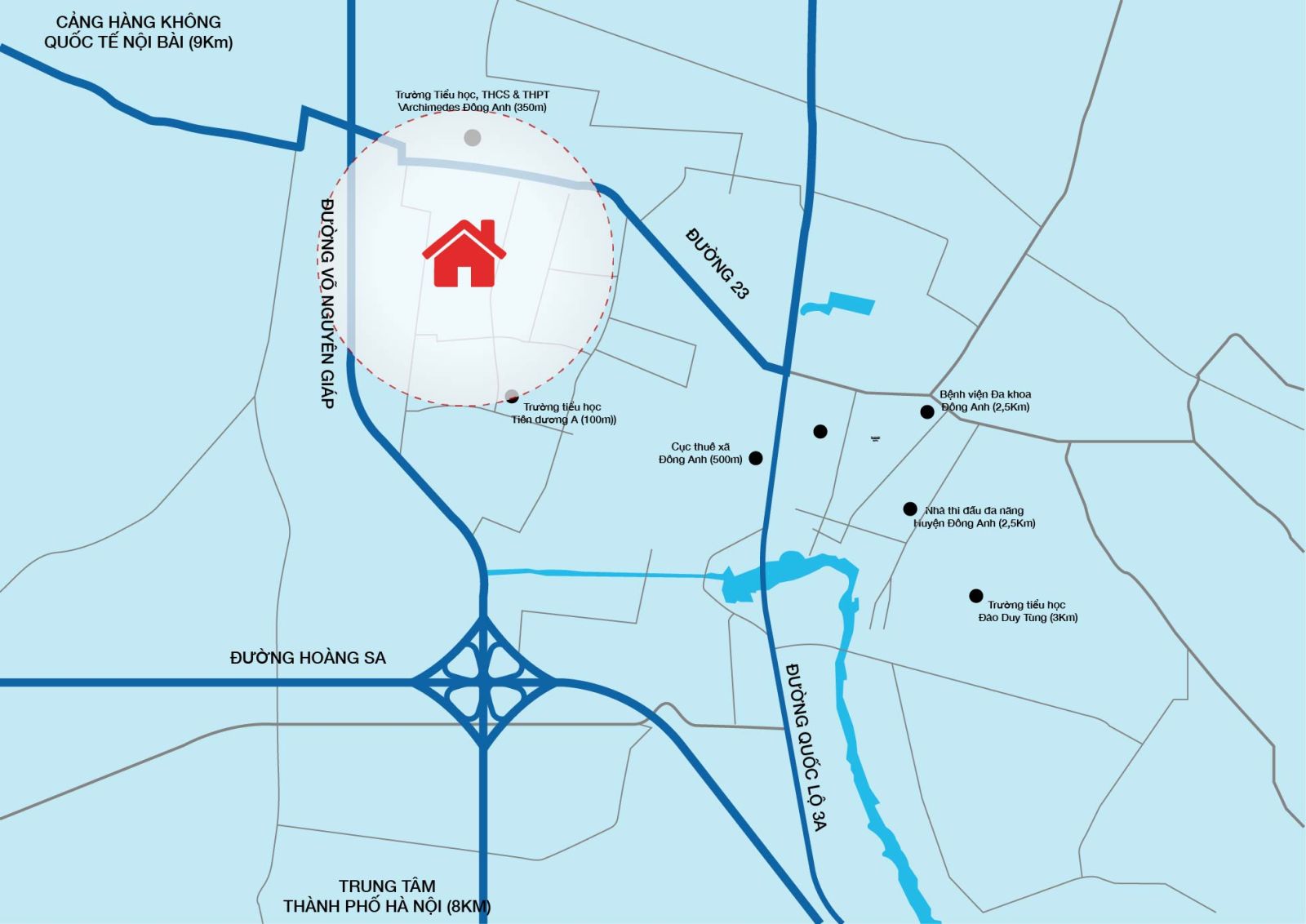

3. Location: Phuc Thinh Commune (according to the new administrative name)
4. Investment Policy: The City People's Committee has issued investment approval decisions No. 6619/QĐ-UBND dated 24/12/2024; Decision No. 1878/QĐ-UBND dated 01/04/2025 approving the Expression of Interest dossier.
5. Investment Objectives: To concretely implement the “Construction of at least 1 million social housing units for low-income residents and industrial workers during 2021–2030” approved by the Prime Minister; in accordance with the City of Hanoi’s Housing Development Program and Plan approved by the City People's Committee; and the 1/500 detailed planning of the pilot concentrated social housing project approved by the City People's Committee. The project aims to build a concentrated social housing area with synchronized technical and social infrastructure, contribute to the city’s housing fund, create urban landscape, and promote socio-economic development of the area.
6. Method of Investor Selection: Investor selection via bidding
7. Land Information, Site Plan, Planning Map, Approved Boundaries:
Land Information: The project is included in the list of works and projects supplementing the 2023 land use plan for Dong Anh District approved by Hanoi People's Committee under Decision No. 4618/QĐ-UBND dated 14/09/2023 (item 42). Land acquisition area: 39.49 ha.
Project Compliance with Planning: General Construction Plan of Hanoi Capital to 2030 with a vision to 2050 approved by the Prime Minister under Decision No. 1259/QĐ-TTg dated 26/07/2011; Urban Subdivision Plan N7, scale 1/5000 approved by Hanoi People's Committee under Decision No. 2270/QĐ-UBND dated 25/05/2012; 1/500 detailed plan of the pilot Tien Duong 2 Social Housing Area approved by Hanoi People's Committee under Decision No. 3175/QĐ-UBND dated 12/06/2019.
Approved Planning Map and Boundaries: According to the plan approved by the City People's Committee under Decision No. 3175/QĐ-UBND dated 12/06/2019.

8. Investment Scale: According to the 1/500 detailed plan approved under Decision No. 3175/QĐ-UBND dated 12/06/2019 with total land use area of approx. 394,900 m², including:
Investor will invest, operate, and exploit residential buildings on approx. 146,265 m² of land (of which approx. 123,171 m² for social housing, 323,094 m² for commercial housing), with a total of approx. 3,458 houses and approx. 267,526 m² of residential floor area; operate commercial-service buildings on approx. 6,677 m² of land, including:
Social apartment buildings: approx. 3,344 units, approx. 210,537 m² floor area, comprising: Rental apartments (minimum 20%) – 669 units, 42,107 m²; Rent-to-own apartments (minimum 10%) – 334 units, 21,054 m²; Apartments for sale (maximum 70%) – 2,341 units, 147,376 m². Each apartment: min. 25 m², max. 70 m²; max. apartment area may increase by up to 10% with the ratio of apartments over 70 m² not exceeding 10% of total social housing units.
Low-rise commercial housing (villas, townhouses): 114 units, 56,989 m² floor area.
Commercial-service buildings (plot CC.DV01): approx. 6,148 m² floor area.
Investor will construct technical infrastructure around plots and hand over to the City and local authorities for management and further development, including:
Educational facilities (kindergarten, primary, secondary schools) on plots MN-01, TH-01, TH-02 – total approx. 32,434 m².
2 centralized parking lots on plots BĐX-01, BĐX-02 – total approx. 12,236 m².
Investor will construct buildings and hand over to specialized agencies or local authorities on remaining land, including:
City, district, and subdivision road network
Internal urban traffic network
Public spaces, green areas, sports and recreational green land
Wastewater treatment station, transformer station
9. Investment Capital: Approx. VND 6,841.667 billion, including:
Estimated total project cost: approx. VND 6,367.787 billion
Compensation and site clearance cost: approx. VND 473.880 billion
10. Implementation Schedule: 2024–2030
11. Project Operation Duration: 50 years from the date the investor receives land allocation/lease/use conversion decision
12. Investment Mechanism: Investor exempted from land use fees and land rent according to law
13. Form of Investment: Non-budget capital
14. Project Proposing Authority: Department of Construction
15. Progress as of Q1/2025: The investment policy was approved by the City People's Committee under Decision No. 6619/QĐ-UBND dated 24/12/2024. Following Decision No. 1877/QĐ-UBND dated 01/04/2025 approving the Expression of Interest dossier, the Department of Construction published the Invitation for Interest and coordinated with relevant departments to carry out the next steps
The housing area is designed with schools from kindergarten to secondary, green spaces, commercial-service facilities, ensuring a convenient life for over 10,000 residents
